TRISHULI 3 B HYDROPOWER PROJECT On High Gear

Despite facing frequent disruptions caused by the Covid-19 pandemic and restrictions, including lockdown and supply constraints due to border closure in Kerung, the 37-MW Upper Trishuli 3B Hydro Electricity Project (UT3BHEP) has made several breakthroughs recently. Thanks to the uninterrupted efforts of Mohan Gautam, Managing Director, Trishuli Jal Vidyut Company Ltd, the project has accelerated its construction pace. As the board of directors visited the site with MD Gautam, they saw the work going on in full swing. That means the project is on track towards its aim of generating electricity by September 2023

March 24, 2022, 5:41 p.m. Published in Magazine Issue: VOL. 15, No. 15, March.25, 2022 (Chaitra,11,2078) Publisher and Editor: Keshab Prasad Poudel Online Register Number: DOI 584/074-75

Several development projects have suffered badly with the spread of COVID-19 and nationwide lockdown but Trishuli 3 B, though at a slow pace, has rarely stopped the work. Along with Covid-19, the project work was also delayed due to the disruption of the supply of equipment from Kerung and China.

With the return of Kul Man Ghising as Managing Director of Nepal Electricity Authority and Chairman of Trishuli Jal Vidhyut Company Limited a year back, the construction work in UT3BHEP has accelerated further.

Along with Ananda Dhungel, project manager of Project manager UT3BHEP, Board of Directors of TJCVL from Nepal Telecom Aananta Man Singh Pradhan, Sangita Pahadee, Rajendra Pradhan and Madan Timsina, DMD from NEA, also visited the site taking note of progress.

Following his reappointment as MD at NEA, Ghising has given high priority to Trishuli 3 B project and backed MD Gautam. That has led the pace of work in Trishuli 3 B to accelerate in high gear.


With MD Ghising’s leadership, Trishuli Jal Vidhyut Company Limited (TJVCL), jointly formed by Nepal Electricity Authority (NEA) and Nepal Doorsanchar Company Limited (NDCL), has handled all the works, financial closure, including the debt portion required for the project, contract agreement and launching of construction, successfully.

With proper guidance and committed management, the project has now achieved every target completing over 57 percent of work by the first week of March 2022 targeting to complete the project by 2023 September.

Led by Managing Director Gautam, who had a long experience working in the construction of projects, including 456 MW Upper Tamakosi and establishing Dudhkosi Storage Hydropower Project, Trishuli Jal Vidhyut Company Limited has begun construction work removing all hurdles to prevent delay in the project.

With complete backing from NEA’s management and the Minister of Energy, Water Resources and Irrigation, MD Gautam and his team have quite efficiently handled all the processes of construction of UT3BHEP.

With the tireless effort of MD Gautam, who prefers to work quietly, UT3BHEP is now back on track. Given the present pace, the project will complete on the stipulated date.

With technical capacity and managerial experience in place, Gautam’s plan of the project perfectly worked before the outbreak of the COVID-19 pandemic. The management now wants the same to repeat.

Commenced on 14 March 2018 with a target to complete by 13 March 2021, over 40 percent of work has been completed till the first week of January or upsurge of Covid-19 Pandemic. However, everything had collapsed within a matter of a month.

Progress

Despite facing a severe crisis of the Covid-19 pandemic followed by health protocols and lockdown, 37 MW Upper Trishuli 3 B Hydropower Project has made a progress completing 58 percent of work.

MD Gautam said that 2865 meters of the main tunnel with a length of 3805 meters has been dug.

"Concreting of structures has started after completion of the excavation of surface powerhouse; work is being done with the aim of concreting the first phase by connecting electromechanical equipment and parts by next May," said Gautam.

"As the customs checkpoints with China have not been fully opened yet, the contractor company has not been able to transport the construction equipment and materials in the production and packaging stage to China and bring them to the construction site. We have received information that they will be released from the customs soon."

A cascade project of 60 MW Upper Trishuli 3A Hydropower Project, the Upper Trishuli 3B will not have to build dams, sand thawing ponds and other structures. The gate required to send the water released from the Upper Trishuli 3A powerhouse to the tunnel of the project has been connected.

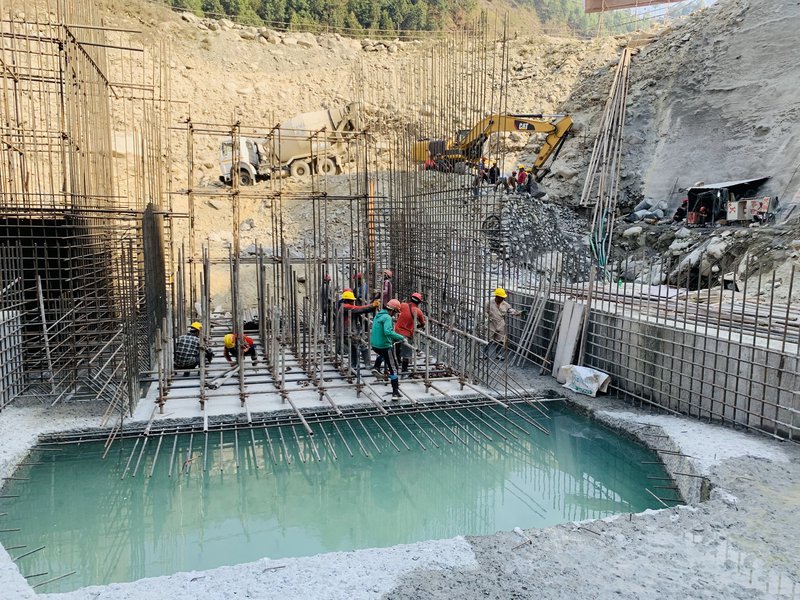

20220305_105605 (1).jpg

Work on the 37 MW Upper Trishuli 3B Hydropower Project under construction in Rasuwa and Nuwakot as a part of the People's Hydropower Program has gained momentum.

The overall physical construction progress of the Upper Trishuli 3B Hydropower Project, which had been hit by the COVID-19 pandemic, has reached 58 percent so far, according to the Nepal Electricity Authority (NEA).

As per the People's Hydropower Program (Operation and Management) Procedure, 2075, there is a provision to demand payment only after paying 50 percent of the remaining amount for the physical progress of the project and all the amount agreed to be taken by the shareholders of the founding group of the company.

IMG_9330-1 (1).jpg

"As the provisions in the working procedure have been completed, the shareholders will be called soon to collect the remaining Rs. 90 per share and other shares in the general public group will also be expedited," said Gautam.

NEA and Nepal Telecom have 30/30 percent founder shares in Trishuli Hydropower Company Limited, the promoter of the project.

The company will have a 5 percent share of Rasuwa and Nuwakot rural municipality and municipality, 5 percent of Rasuwa and Nuwakot local financial institutions, 10 percent of Rasuwa and Nuwakot residents, 15 percent of public and 5 percent of NEA and Telecom employees.

The estimated construction cost of the project is Rs. 7.44 billion.

The construction of the project, which was in full swing, was halted for about 15 months as Chinese workers, who had gone home in the second week of January 2020 to celebrate the New Year, could not return due to COVID-19 and equipment and materials could not be brought from China.

The construction of the project was resumed only from April 2021, but the work was again affected for about three weeks due to the second and third waves of COVID-19.

Also, construction was affected by the discovery of a much weaker rock than previously estimated in the main tunnel. Contractor Chinese company Shuifa ANHE Group Co. Ltd. is currently constructing main structures, including intake, main tunnel and powerhouse.

The contract agreement was signed with Shuifa ANHE Group Company on February 12, 2018, for the construction of the project in the Engineering, Procurement and Construction (EPC) model. The contractor company will design, construct, connect and operate all the civil, electromechanical and hydromechanical side structures and equipment of the project.

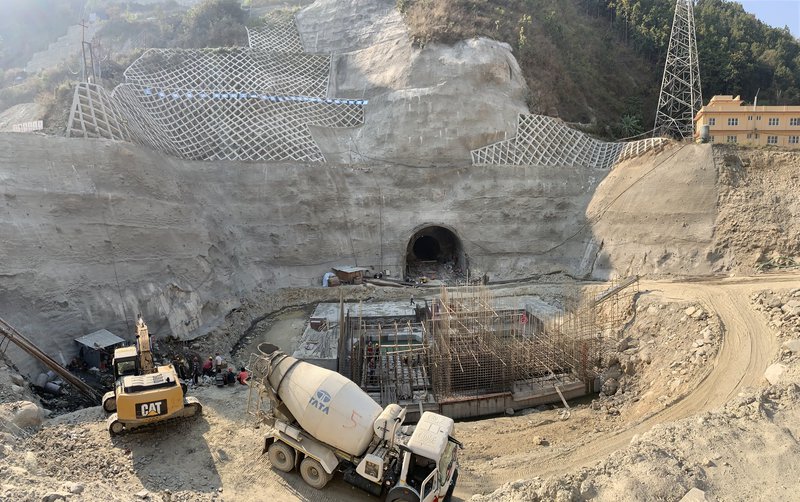

20220305_113051 (1).jpg

The electricity generated will be transmitted to the national grid through the existing Samundartar Trishuli 3B transmission line.

Quick collection of the remaining amount for shares The promoter of the project, Trishuli Hydropower Company Limited, will soon collect the remaining amount for the shares issued under the People's Hydropower Program.

The company had issued 3.7 million shares to the public and collected only Rs. 10 per share with a minimum face value of Rs. 100.

As per the People's Hydropower Program (Operation and Management) Procedure, 2075, there is a provision to demand payment only after paying 50 percent of the remaining amount for the physical progress of the project and all the amount agreed to be taken by the shareholders of the founding group of the company.

"As the provisions in the working procedure have been completed, the shareholders will be called soon to collect the remaining Rs. 90 per share and other shares in the general public group will also be expedited," said Gautam.

NEA and Nepal Telecom have 30/30 percent founder shares in Trishuli Hydropower Company Limited, the promoter of the project.

The company will have a 5 percent share of Rasuwa and Nuwakot rural municipality and municipality, 5 percent of Rasuwa and Nuwakot local financial institutions, 10 percent of Rasuwa and Nuwakot residents, 15 percent of public and 5 percent of NEA and Telecom employees.

Trishuli 3 B project Site

The period from November to the first week of June is regarded as the best time to achieve progress in the civil and other surface construction work because of favorable weather. Following the onset of the monsoon in June, progress will be slowed down naturally. However, the disruption that started after January till now has pushed everything behind. Given the present scenario, there might be a delay of 6-8 months in completing the Project.

“Although the construction of the project was going on smoothly till the 3rd week of January 2020, the COVID-19 has changed the status of the project,” said MD Gautam.

The estimated construction cost of the project is Rs. 7.44 billion. The completion of UT3BHEP will help to maintain the quality of the electricity supply in the Kathmandu Valley.

NEA’s MD Ghising is making efforts to shorten the period of delay. In his effort, MD Ghising has started to facilitate the work to bring the equipment and materials lying in Keirung.

With his own experiences and backing of NEA and top management, MD Gautam is now pushing the contractors to make tangible progress to complete it.

Salient Feature

SALIENT FEATURES OF UPPER TRISHULI 3B HYDROELECTRIC PROJECT

General

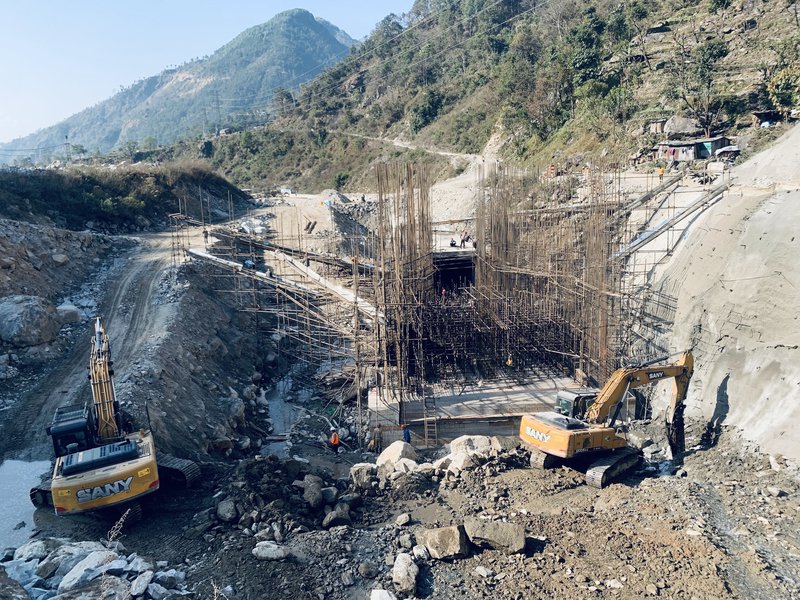

IMG_9233-1 (1).jpg

Location: -Kispang Rural Municipality (Nuwakot), Uttargaya Rural Municipality (Rasuwa)

Type of Scheme: - Run-of-River (Cascade of Upper Trishuli 3A Hydroelectric Project)

Gross Head: - 90 m

Installed Capacity: -37 MW

Average Annual Energy after Outage: 292.58GWh/year

Dry Season:- 134.88 GWh/ year

Wet Season:- 157.70 GWh/year

Penstock

Length: - 185.33m

Diameter: - 4.2m

Thickness: - 18 mm

Hydrology

Catchment Area: - 4577 km2

Design Discharge (at 70 % PoE): - 51 m3/sec

Powerhouse

Type: - Surface

Size (L X BXH): - 40.4 m x 19.30m x 33.81 m

Head Pond (Connected to UT3A Tailrace Pond)

Size: 29(L) x 5.2 to 11.0(B)x 7.35 to 14.8 (H)

Lowest Bed Level: - 714.20 m

Intake: - Bell Mouth Type

Tailrace Conduit

Type: - RCC

Length :- 180m (5.323 m (B) x 3.6 m (H))

Approach Pressure Conduit

Type: - Box Culvert

Length: -243.47 m + 40 m

Size: - 5.1m x 5.1m Square and 5.1 m diameter

Turbine

Type: - Vertical Axis Francis

Capacity: - 2X19.715MW

Headrace Tunnel

Shape: - Horseshoe

Length: - 3805.48m

Diameter: - 5.1m ~ 6.1 m

Generator

Type: - 3 Phase Synchronous

Capacity :- 2 X 22.7045MVA

Adit Tunnel

Shape: - Inverted D

Length of Adit 1: - 463.3 m, Diameter: - 4.0m +1.5 m

Length of Adit 2: 119.17m Diameter: -5.95 m ~ 6.1 m

Transformer

Type: - 3 Phase Oil Immersed Outdoor ONAN

Capacity: - 2X 23 MVA

Voltage Ratio:- 11 kV /132 kV

Surge Tank

Type: - Restricted Orifice

Diameter: - 15.0 m

Height: - 39.3 m

Transmission Line

Voltage Level:- 132 kV, Double Circuit (3 km)

Construction Period: -1095 Days from Commencement Date

Commencement Date: - 14 March, 2018
