Nepal Electricity Authority cancels contract worth over Rs 1 billion, now electricity wires going to customers' homes are bare

Nepal Electricity Authority cancels contract worth over Rs 1 billion, now electricity wires going to customers' homes are bare

April 21, 2025, 9:31 a.m.

Nepal Electricity Authority (NEA) has started canceling one tender after another, citing a shortage of cash flow.

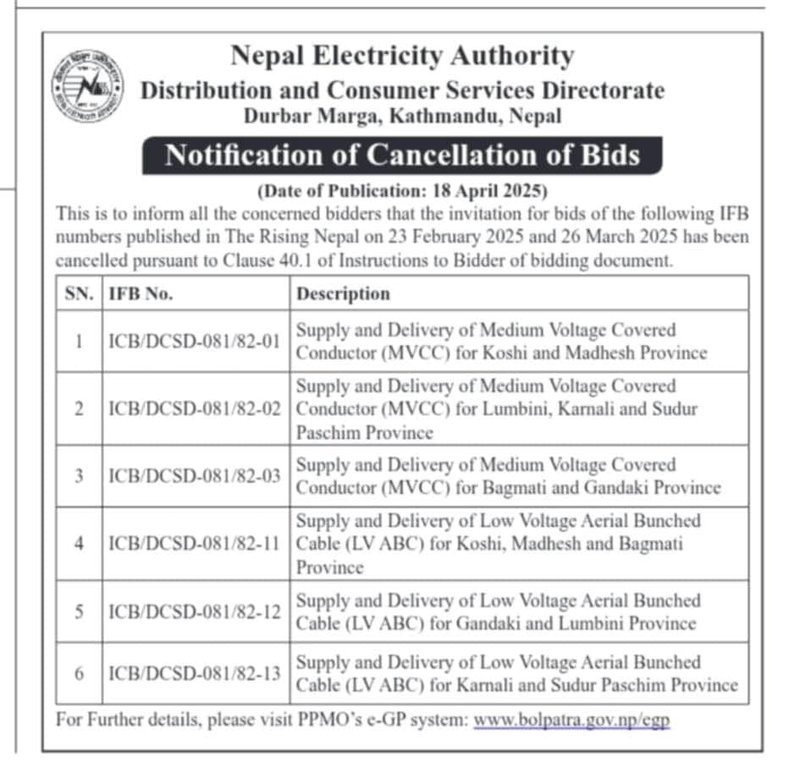

According to Jalasarokar.com, a leading energy focused online, the authority cancelled the tender for making distribution lines safe (MVCC) and LV ABC) worth more than one billion rupees on Friday after the deadline for submitting tenders expired.

The tender for the project to convert approximately 3,300 kilometers of bare conductors to covered conductors across the country has been canceled said online.

The NEA had been converting bare wires into covered wires for the past few years with the aim of preventing electrical accidents, extending lines to customers' homes without cutting down trees and branches, preserving greenery, and reducing electrical leakage. This campaign was conducted across the country.

For this purpose, the NEA had opened a tender on March 21 and given a deadline of March 21. This tender was canceled after the government removed the NEA's Executive Director, Kulman Ghising, on March 21.

The authority had tendered for Medium Voltage Covered Conductor (MVCC) for Koshi, Madhes, Lumbini, Karnali, Far West, Bagmati and Gandaki provinces and Low Voltage Aerial Bunched Cable (LV ABC) for Koshi, Madhes, Bagmati, Gandaki, Lumbini, Karnali and Far West.

According to a provincial head of the authority, a campaign to install protected cables instead of bare wires was being conducted across the country to strengthen the electricity system, reduce faults, and protect people's lives.

Although it costs one and a half times more than the previous bare wire, the NEA has given it a high priority because it eliminates the need to cut down trees and their branches, eliminates the problem of wires tangling in the wind, reduces electrical accidents, and reduces technical leaks at the NEA.

MVCC is for 11 kV (11,000 volts) wires and LV ABC is for 400 voltage. Prajwal Khadka, head of the NEA's Commodity Management Division, said that six of the tenders were canceled due to a decrease in the NEA's cash flow.

Its estimated cost is more than one billion rupees.

The authority had only last week postponed the work of providing the necessary transformers and extending the line to open a new charging station for electric vehicles.RPP General Secretary Rana released on bail
